Willoughby Leisure Centre Upgrade

Share Willoughby Leisure Centre Upgrade on Facebook Share Willoughby Leisure Centre Upgrade on Twitter Share Willoughby Leisure Centre Upgrade on Linkedin Email Willoughby Leisure Centre Upgrade link

Construction work is now underway to upgrade the Willoughby Leisure Centre to create a modern, best in breed new aquatic and recreation facility.

During this upgrade, which will run until 2025, the centre's:
- School holiday program and gym will continue to operate
- Indoor courts will predominantly remain open, but may need to close for some period during construction; and
- Pool hall and creche will remain closed

This page has been created to let people know about the improvements, along with news on any impacts on key users during the construction process.

Construction work is now underway to upgrade the Willoughby Leisure Centre to create a modern, best in breed new aquatic and recreation facility.

During this upgrade, which will run until 2025, the centre's:
- School holiday program and gym will continue to operate
- Indoor courts will predominantly remain open, but may need to close for some period during construction; and
- Pool hall and creche will remain closed

This page has been created to let people know about the improvements, along with news on any impacts on key users during the construction process.

  • Latest project update - November 2024.

    Share Latest project update - November 2024. on Facebook Share Latest project update - November 2024. on Twitter Share Latest project update - November 2024. on Linkedin Email Latest project update - November 2024. link

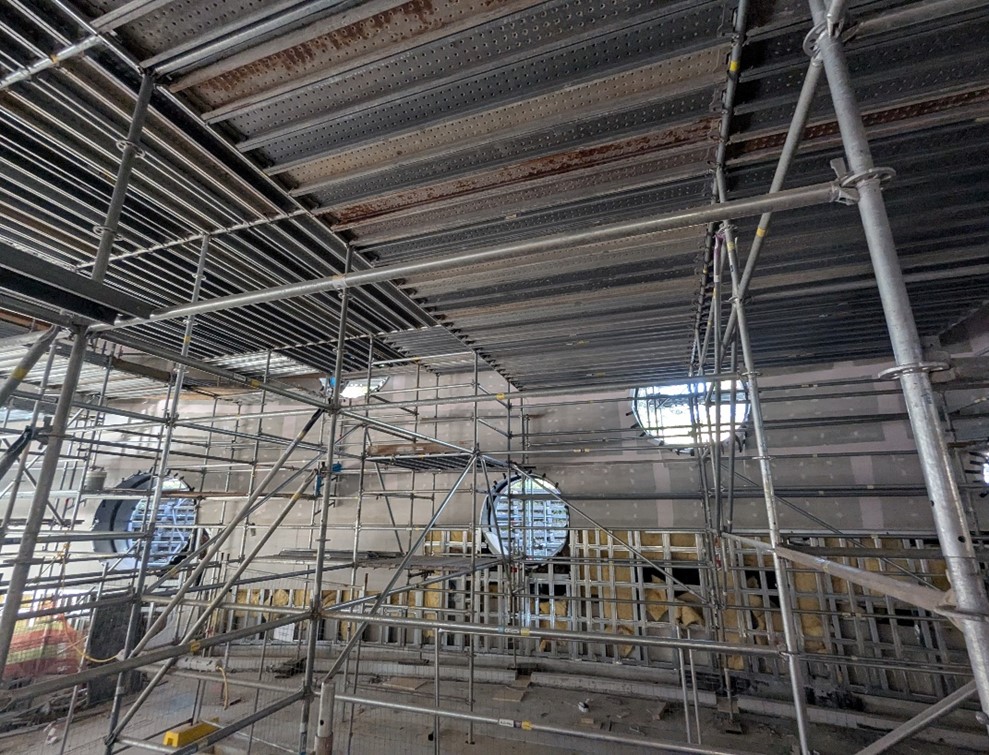

    Construction progress on site over last month

    • Concourse slab around pools complete
    • Leakage test passed for Learn to Swim Pool & Program Pool
    • Scaffold ‘bird cage’ installed for steel framework construction
    • Structural steel (Columns & curved roof beams) erection on northern sector of the site

    Focus of construction work in coming month

    • Structural steel (Columns & curved roof beams) erection on southern sector of the site
    • Delivery to site of electrical substation
    • Surface preparation for floor finishes/tiling on Learn to Swim Pool & Leisure Pool
    • Existing plant room slab integration


    Completed works

    Since the pool closed on 19 November 2022, the following works have been completed:

    • Site establishment
    • Demolition of the old pool hall
    • Implementation of Environmental Protection Authority (EPA) approved Asbestos Management Plan protocols with excavation and removal of some asbestos contaminated soil.
    • Construction of new piles to support the pool hall
    • Structural retaining wall on the site’s north-eastern boundary completed
    • Capping of contaminated soil on 100% of the site
    • New stormwater line in Small Street
    • Below ground backwash tanks for the 25m and program pools
    • Pool Concrete shells are complete for the 25m Pool, Program Pool, Learn to Swim Pool and Spa
    • Concrete ring beams to support steel columns
    • Concrete slabs for upper level plant rooms
    • Structural steel columns & roof beams to northern sector of the site

    Other relevant project updates over the last month

    • Continuation of the Asbestos Management Plan - daily air monitoring continuing

    Centre facilities currently open

    • Health club and sports hall, including a full range of land-based group fitness classes

    Expected project completion date

    • 2025

  • Important update coming early in 2025

    Share Important update coming early in 2025 on Facebook Share Important update coming early in 2025 on Twitter Share Important update coming early in 2025 on Linkedin Email Important update coming early in 2025 link

    A progress report on upgrades to the Willoughby Leisure Centre will be submitted to Council in the first quarter of 2025.

    Following review of the report, we anticipate being able to provide a more information re the timeline for project completion and date for the opening of the new pool.

    We’ll provide further updates on this page, as more information becomes available.

  • Latest project update - October 2024

    Share Latest project update - October 2024 on Facebook Share Latest project update - October 2024 on Twitter Share Latest project update - October 2024 on Linkedin Email Latest project update - October 2024 link

    Construction progress on site over last month

    • Concourse slab around pools is predominately complete
    • Family Change Room – Walls & columns poured
    • Upper plant room – Concrete slab above family change room complete
    • Concrete walls around eastern spa area poured
    • Water testing of pools
    • Scaffold ‘bird cage’ installed for steel framework construction
    • Ring beam to support the pool hall’s structural steel complete

    Focus of construction work in coming month

    • Structural steel delivery to site
    • Erection of structural steel columns & beams for northern end of the site
    • Completion of pool cover concrete boxes
    • Completion of concourse slab
    • Existing plant room slab integration
    • Filtration pipes to southern wall void to be installed
    • Completion of slab base for Electrical Sub Station


    Completed works

    Since the pool closed on 19 November 2022, the following works have been completed:

    • Site establishment
    • Demolition of the old pool hall
    • Implementation of Environmental Protection Authority (EPA) approved Asbestos Management Plan protocols with excavation and removal of some asbestos contaminated soil.
    • Construction of new piles to support the pool hall
    • Structural retaining wall on the site’s north-eastern boundary completed
    • Capping of contaminated soil on 100% of the site
    • New stormwater line in Small Street
    • Below ground backwash tanks for the 25m and program pools
    • Pool Concrete shells are complete for the 25m Pool, Program Pool, Learn to Swim Pool and Spa
    • Concrete ring beams to support steel columns

    Other relevant project updates over the last month

    • A new time lapse video, showing construction between January and July 2024, has been added to the project website.
    • Continuation of the Asbestos Management Plan - daily air monitoring continuing

    Centre facilities currently open

    • Health club and sports hall, including a full range of land-based group fitness classes

    Expected project completion date

    • 2025

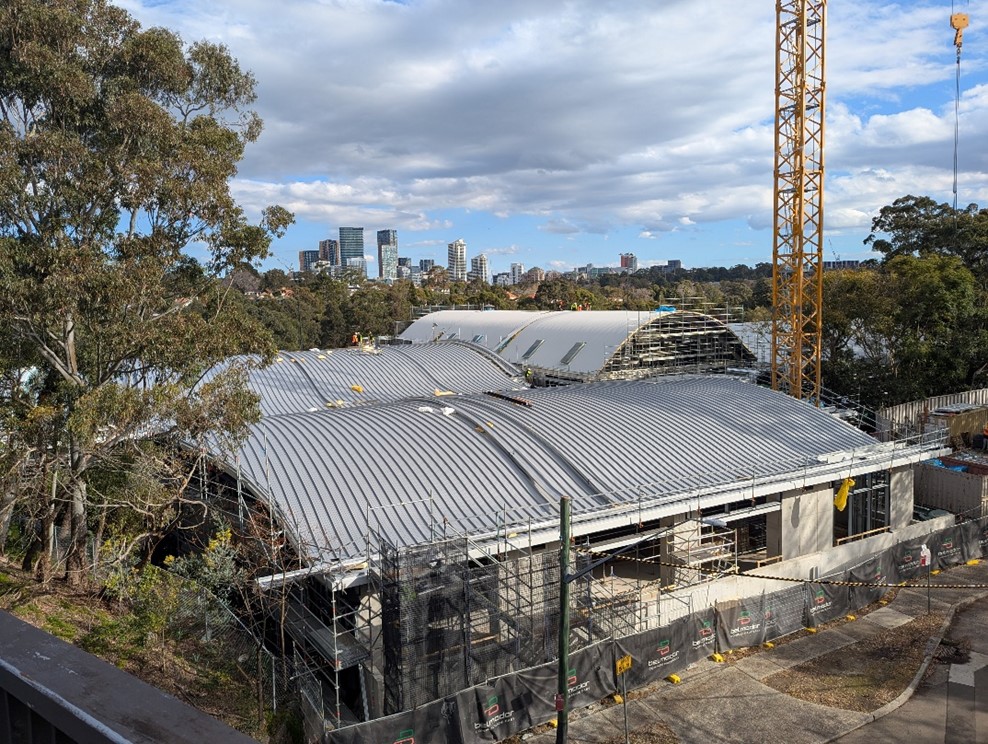

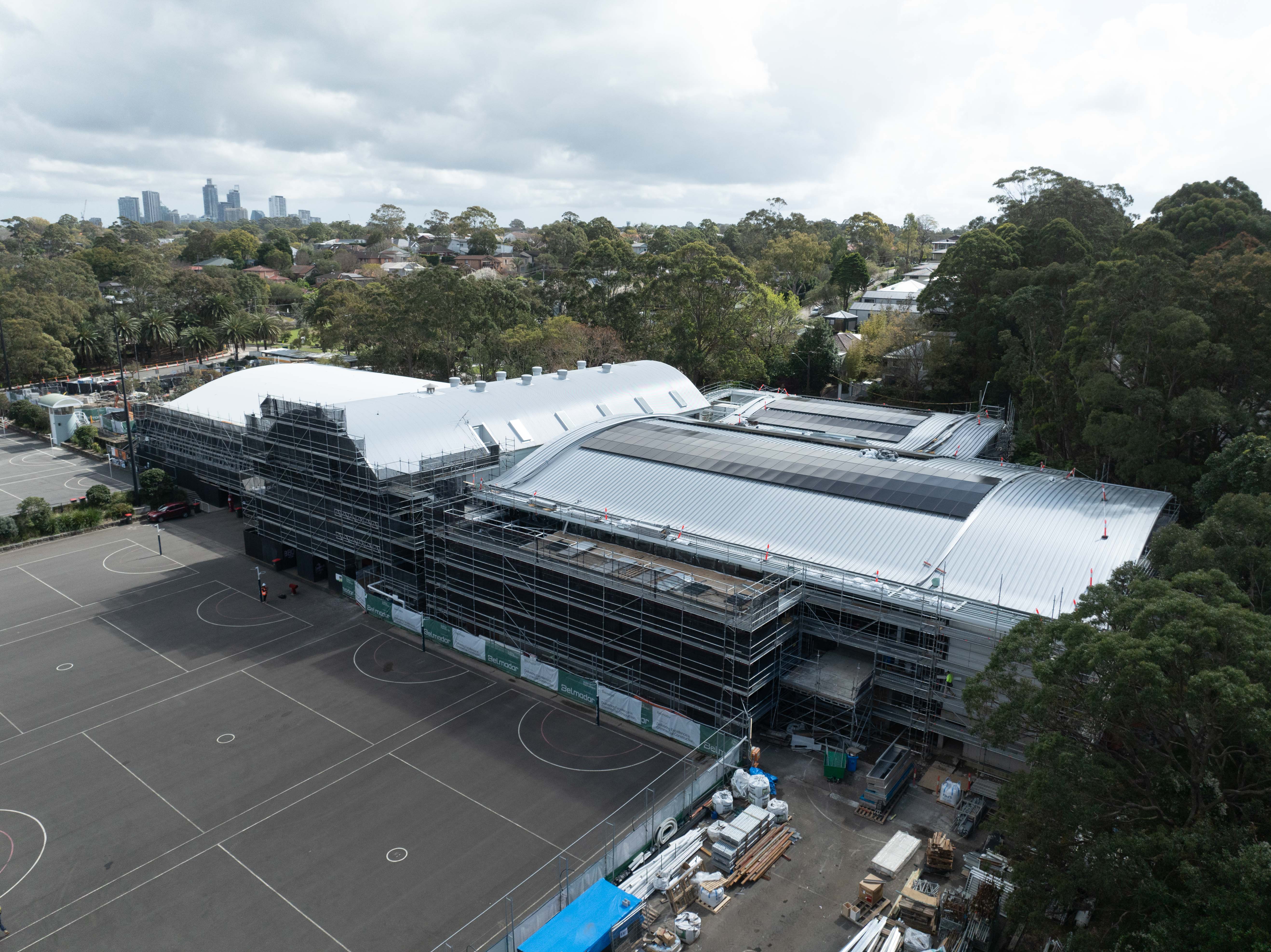

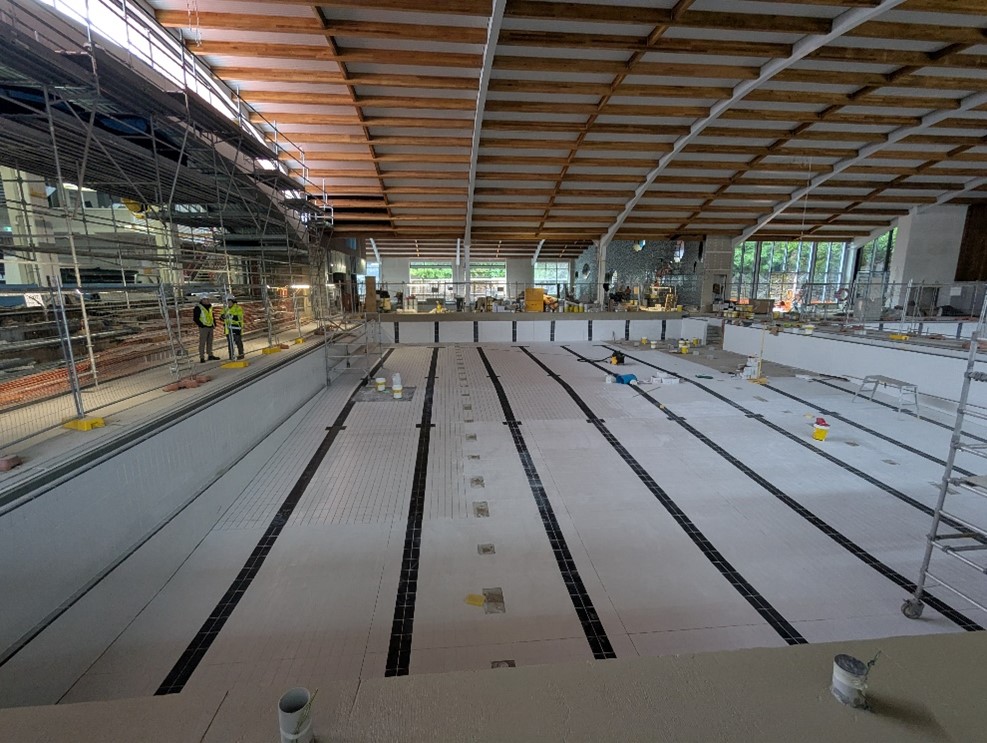

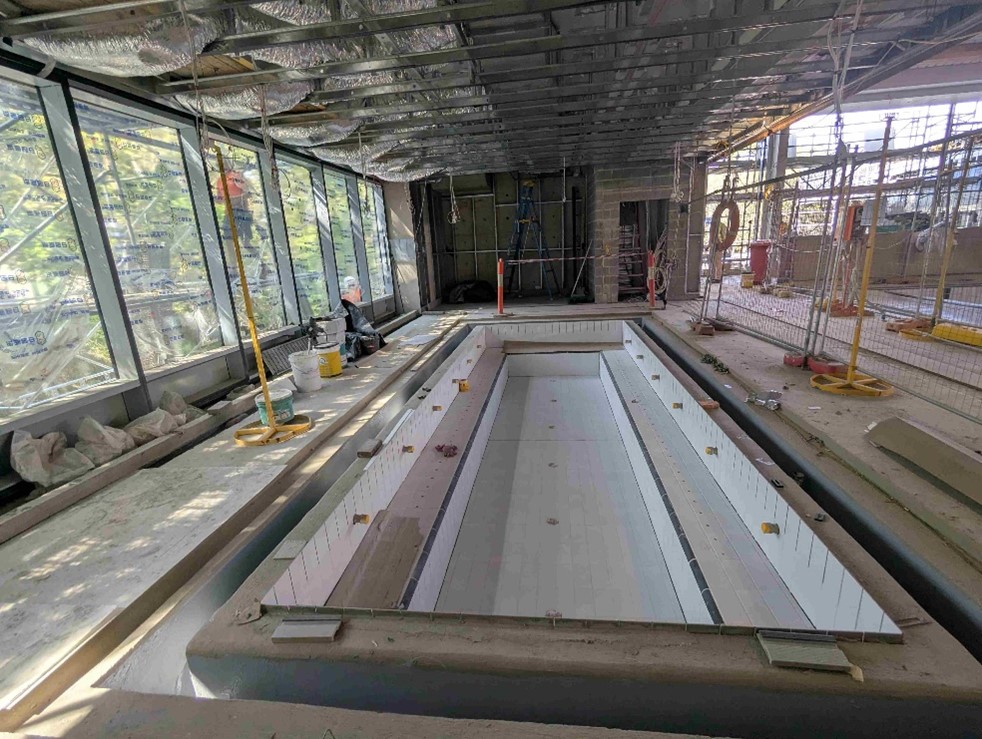

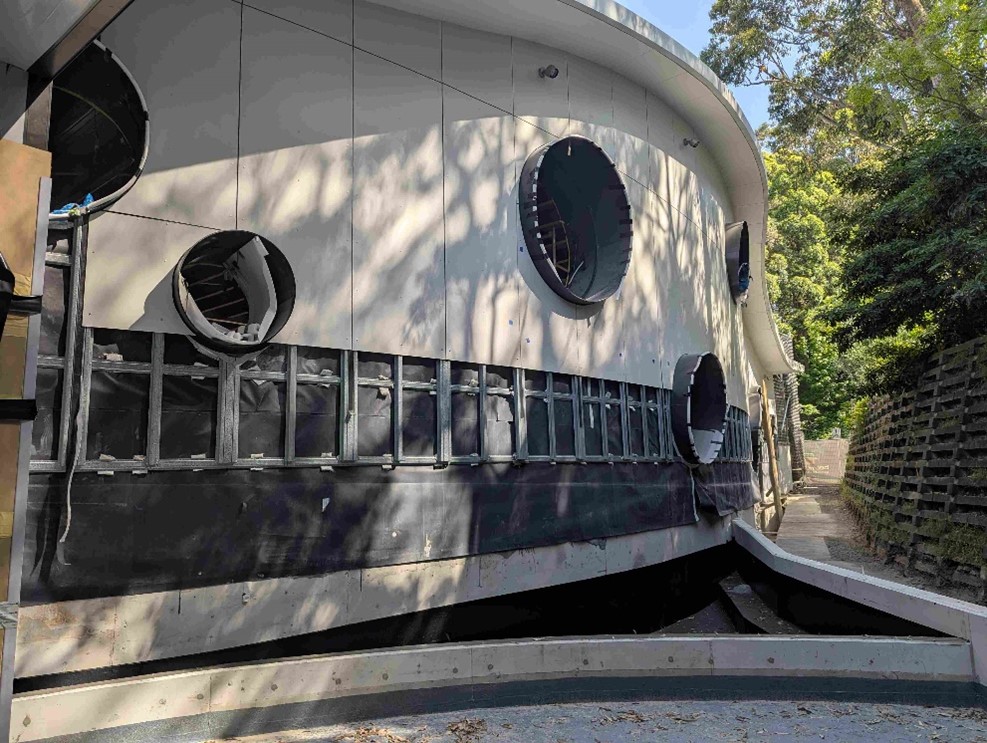

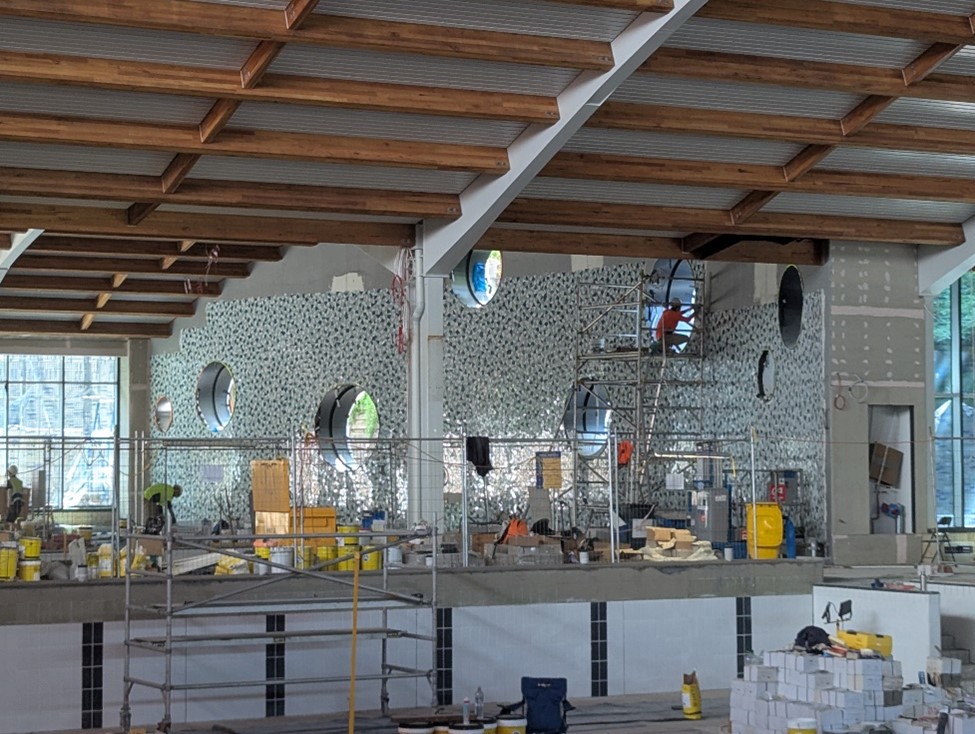

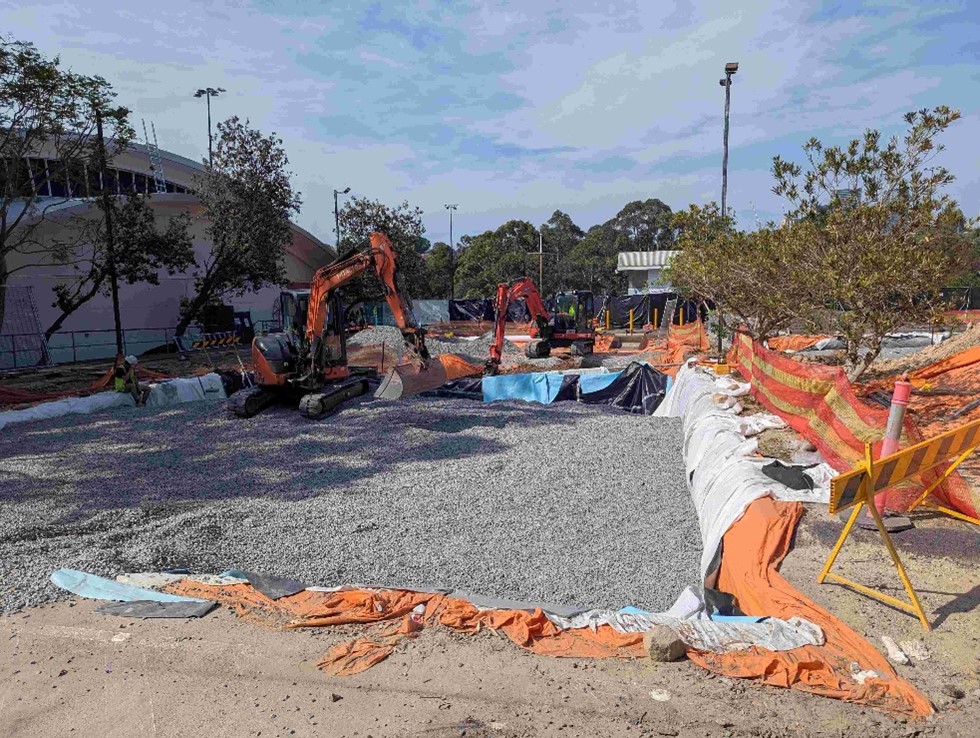

    Project photographs from October 2026.



  • Latest project update - September 2024

    Share Latest project update - September 2024 on Facebook Share Latest project update - September 2024 on Twitter Share Latest project update - September 2024 on Linkedin Email Latest project update - September 2024 link

    Construction progress on site over last month

    • Leisure pool – concrete base and walls poured
    • Program Pool – pool covers - concrete poured
    • Family change room – concrete slab poured
    • Concrete poured for ring beam to support the pool hall’s structural steel underway

    Focus of construction work in coming month

    • Concrete pour for a portion of the pool hall concourse slab
    • 25m Pool – concrete pour for ramps
    • Program Pool – pour pool cover base
    • Spa – concourse – concrete pour
    • Commence erection of scaffolding to construction steel framework
    • Steel framework for northern end of pool hall due to arrive on site

    Completed works

    Since the pool closed on 19 November 2022, the following works have been completed:

    • Site establishment
    • Demolition of the old pool hall
    • Implementation of Environmental Protection Authority (EPA) approved Asbestos Management Plan protocols with excavation and removal of some asbestos contaminated soil.
    • Construction of new piles to support the pool hall
    • Structural retaining wall on the site’s north-eastern boundary completed
    • Capping of contaminated soil on 100% of the site
    • New stormwater line in Small Street
    • Below ground backwash tanks for the 25m and program pools
    • Pool Concrete shells are complete for the 25m Pool, Program Pool, Learn to Swim Pool and Spa

    Other relevant project updates over the last month

    • A new time lapse video, showing construction between January and July 2024, has been added to the project website.
    • Continuation of the Asbestos Management Plan - daily air monitoring continuing

    Centre facilities currently open

    • Health club and sports hall, including a full range of land-based group fitness classes

    Expected project completion date

    • 2025



    View of completed pool shells


    Family change room – concrete slab pour

  • Timelapse video January to July 2024

    Share Timelapse video January to July 2024 on Facebook Share Timelapse video January to July 2024 on Twitter Share Timelapse video January to July 2024 on Linkedin Email Timelapse video January to July 2024 link


  • Announcements

    Share Announcements on Facebook Share Announcements on Twitter Share Announcements on Linkedin Email Announcements link

    On Tuesday, 3rd September 2024, there will be increased truck movements and noise as Belmadar undertake a large and complex pour concrete pour for the Leisure Splashpad pool. This the final pool to be poured and due to the number of water features it includes, may take longer than planned. Nearby residents have been notified of the works.

  • Latest project update - August 2024

    Share Latest project update - August 2024 on Facebook Share Latest project update - August 2024 on Twitter Share Latest project update - August 2024 on Linkedin Email Latest project update - August 2024 link

    Construction progress on site over last month

    • 25m pool – concrete shell for pool and pool covers complete

    • Program Pool – concrete shell complete

    • Learn to Swim pool – concrete shell complete

    • Subfloor plumbing for the water jets and play features and concrete pour for the Childrens Leisure Pool completed

    • Spa walls concrete shell complete and pool cover base poured

    • Family change room – formwork commenced

    • Formwork for the ring beam to support the pool hall’s structural steel underway

    Focus of construction work in coming month

    • Leisure Pool – pour concrete to base slab & walls on the 3rd September 2024

    • Work will progress with the pool hall concourse concrete slab

    • 25m Pool – concrete pour for ramps

    • Program Pool – pour pool cover Base

    • Spa – pour blanket cover walls

    • Family Change Room – pour floor slab


    Completed works

    Since the pool closed on 19 November 2022, the following works have been completed:  

    • Site establishment

    • Demolition of the old pool hall  

    • Implementation of Environmental Protection Authority (EPA) approved Asbestos Management Plan protocols with excavation and removal of some asbestos contaminated soil.

    • Construction of new piles to support the pool hall

    • Structural retaining wall on the site’s north-eastern boundary completed

    • Capping of contaminated soil on 100% of the site

    • New stormwater line in Small Street

    • Below ground backwash tanks for the 25m and program pools

    • Pool Concrete shells are complete for the 25m Pool, Program Pool, Learn to Swim Pool and Spa

    Other relevant project updates over the last month

    • Continuation of the Asbestos Management Plan - daily air monitoring continuing

    Centre facilities currently open

    • Health club and sports hall, including a full range of land-based group fitness classes

    Expected project completion date

    • 2025

    Image from crane camera, 20 AugustChildren's Leisure pool from work

    Spa




  • Timelapse Video - September 2023 - January 2024

    Share Timelapse Video - September 2023 - January 2024 on Facebook Share Timelapse Video - September 2023 - January 2024 on Twitter Share Timelapse Video - September 2023 - January 2024 on Linkedin Email Timelapse Video - September 2023 - January 2024 link


Page last updated: 05 Dec 2024, 04:16 PM
